- TODAY · THIS ARTICLEA 440-ton slice of steel rolled through the gates of the world’s biggest fusion experiment before dawn in southern France, the ninth and last piece of a plasma chamber that will weigh 5,732 tons welded together, and each slice already carries 93 miles of factory welds
Fusion power comes with a running joke you’ve probably heard: it’s always 20 years away, and it’s been that way for about 60 years now.

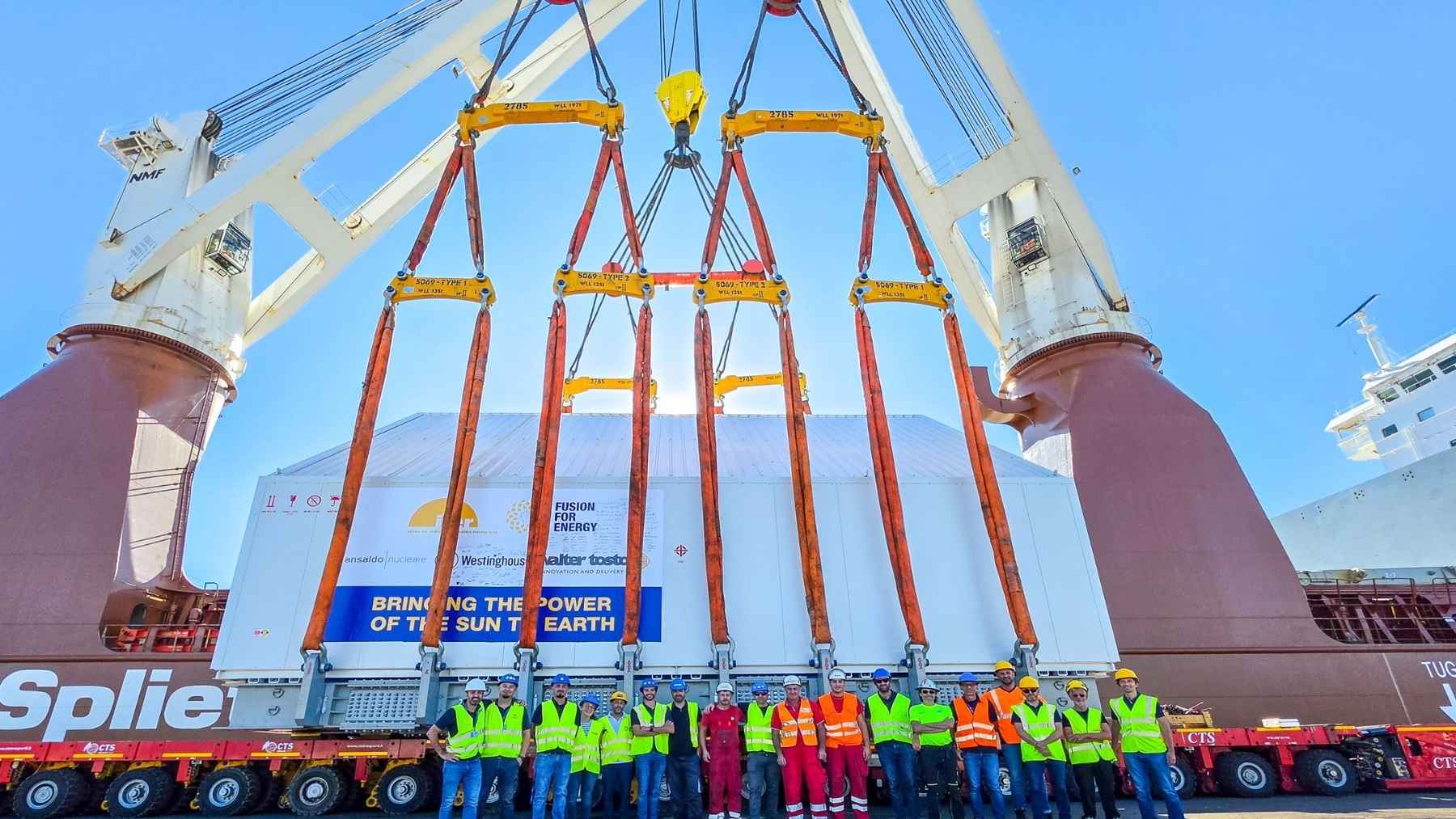

It’s fun to joke about, since laughing keeps us from crying over technology delays. Luckily, the joke hasn’t slowed the hardware down any. In southern France, the biggest fusion experiment on the planet has spent years collecting parts from factories on three continents, and early Friday morning, October 2nd, the last big one rolled through the gate.
That part’s vacuum vessel sector #2, the ninth and final slice of the plasma chamber at the heart of ITER. We covered its send-off from the factory in Italy back in September, when the arrival was still a date on a calendar. Now it’s finally done traveling. According to the ITER Organization, the load that arrived measured nearly 48 feet long, 32 feet wide, and 28 feet tall, and weighed 639 tons, including protective packaging and steel frame.
Why are we adding the packaging? The bare steel section weighs more than 440 tons on its own, and the rest of the load is the white crate and the cradle that kept it safe on the road. You don’t haul a precision-machined component across two countries without wrapping it up first.
So what exactly is a vacuum vessel?
The vacuum vessel is the chamber where the fusion reaction will actually happen. Picture a double-walled steel donut. Now picture a double-walled steel donut in which superheated plasma swirls inside, while enormous magnets keep that plasma from ever touching the walls. You can see why: the plasma inside will run about 270 million degrees Fahrenheit, and the walls, thick as they are, are still metal. The vessel also doubles as the machine’s first containment barrier.
The finished ring will measure nearly 64 feet across, stand about 37 feet tall, and weigh 5,732 tons once all nine sections are welded together. Five of those sections were built in Europe by a consortium of Ansaldo Nucleare, Westinghouse, and Walter Tosto, and sector #2 was finished at a workshop in Monfalcone, Italy. The other four came from Korea, and the first of them showed up six years ago.
One figure made me read it twice. Fusion for Energy, the EU agency handling Europe’s share of ITER, says each section carries roughly 93 miles of weld beads from fabrication alone. That’s a wildly absurd amount of welding to pack into one piece of steel. And yet it happens before anyone at the ITER site so much as picks up a torch.
The monster convoys are over
Getting this thing to the site was a production in itself. The section left Italy by ship in mid-September and, according to ITER Newsline, reached Marseille on September 21. The next morning, it came out of the cargo hold at the Port of Marseille Fos as the sun was rising, and on September 23rd, a specialized barge carried it across an inland lagoon near the port. From there, it rode the ITER Itinerary, a 64.6-mile route that was widened and reinforced years ago specifically so loads like this one could creep along it at night.
ITER files deliveries this size under a category it calls “Super Highly Exceptional Loads.” Every giant toroidal field coil came in under that label, along with the large ring-shaped poloidal field coils built off-site and all nine vacuum vessel sections. Sector #2 closed the list out, and ITER says every load in the category’s now safely on site. A freight category retiring is a pretty strange thing to feel anything about. Still, after more than a decade of these night convoys, I kind of get it.
So is the chamber finished?
Not even close. So… Yeah, the joke about it being 20 years away is still relevant. Although hopefully not accurate.
Nine sections on site mean the shopping’s done, and there are still years of work left in the assembly. Each section first gets dressed for duty: crews wrap it in a polished thermal shield, the last of 27 panels, ITER unpacked on September 30th, and bolt on a pair of D-shaped toroidal field coils. The whole package becomes what ITER calls a sector module, weighing about 1,320 tons, and an overhead crane lowers it into the tokamak pit. We watched one of those modules go down into the pit earlier this year.
Six of the nine modules were already in the pit by early September. Sector #3 then moved into the assembly tooling on September 18th, the fastest transfer the project has ever pulled off, and its module’s due to go into the pit in early 2027 as the eighth of nine. ITER hasn’t said when sector #2 itself makes that trip, though it’s safe to assume the newest arrival goes last.
Then the welding starts. ITER calls joining the nine sections into a single leak-tight chamber one of the most demanding phases of the entire assembly, and it’s been running the three specialized welding machines for that job through their paces at a new trial facility since September. I wouldn’t bet on that phase being quick (trust me). 93 miles of factory welds per section got the pieces this far, and the seams joining sections are still ahead. They’ll be welded in place, by hand and by machine, inside the pit.
Sector #2 rolled through the ITER gates on October 2nd, 2026, six years after the first section arrived. ITER says sector #3’s completed module should head into the tokamak pit in early 2027, and after that, the welders take over.
